Ponds and dams

The Tenas mine would keep its acid-generating waste rock under water in three ponds, held by four earth dams on a hillside above the Telkwa River. This page describes the ponds and dams, how their liners hold water and let it seep, where our flood maps come from, and what Telkwa Coal's own study says would happen if a dam failed.

In brief

Three of the dams hold back ponds where the Tenas mine would store its acid-generating waste rock under water, permanently. The fourth holds a settling pond below them. Each pond floor carries a 30 cm liner of soil mixed with bentonite clay, which lets water seep slowly into the ground beneath, about 1,600 cubic metres a day by 2024 figures. In 2021 Telkwa Coal's engineers, SRK Consulting, modelled what would happen if the dams failed. Their study estimates that a failure would put up to about 200 more people in a flood's path, most of them in the Village of Telkwa, 11 kilometres downstream. Our flood maps are that study's figures. The same study, unchanged, was filed again in 2026.

4earth dams: West, East, North, and the Tenas Control Pond dam
40 mgreatest height, at the East Dam, which is 3.2 km long
up to 200additional people put at risk by a failure, by SRK's estimate
3 to 4 hoursfor a flood wave to reach Telkwa if a dam fails during a major flood; 6 to 8 hours in fair weather

All four figures come from Telkwa Coal's Dam Breach Assessment Report of April 2021. That report says its predictions "may vary significantly" from what would happen.

What the ponds and dams are

The Tenas mine would dig up rock that turns water acidic when exposed to air. The plan keeps that rock under about two metres of water for good, in three "management ponds" built on a hillside between Tenas Creek and Goathorn Creek. An earth dam holds each pond. A fourth dam holds the Tenas Control Pond, which sits downhill and collects what flows out of the other three. Source: Dam Breach Assessment Report, SRK, Apr 2021, p. 12.

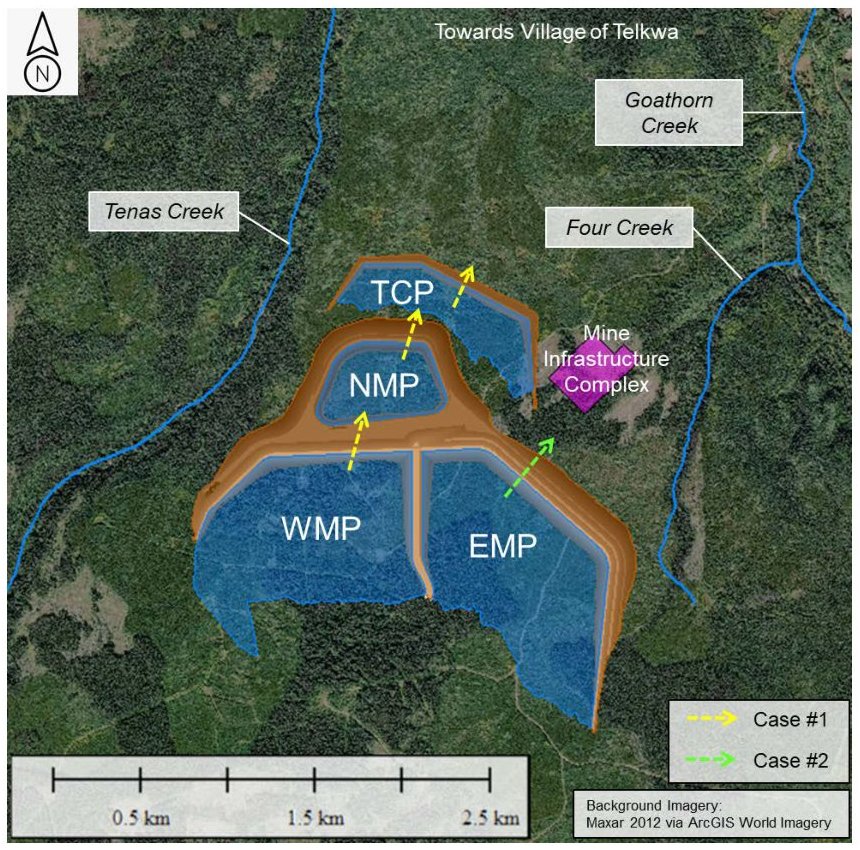

Aerial plan showing four ponds: the Tenas Control Pond at the top, the North Management Pond below it, and the West and East Management Ponds side by side at the bottom. Arrows show two failure paths.
Four ponds, from Figure 1-2 of SRK's study. TCP is the Tenas Control Pond; NMP, WMP and EMP are the North, West and East Management Ponds. Yellow arrows mark a first modelled failure (West, then North, then the control pond). A green arrow marks a second (the East Dam, towards the mine buildings). Open page 12 of this report.See it on our map →
DamLengthGreatest heightStorage to crestHolds
West1,511 m37 m36.2 million m³Waste rock under water
East3,225 m40 m17.5 million m³Waste rock under water
North1,173 m27 m4.1 million m³Waste rock under water
Tenas Control Pond1,876 m18 m2.3 million m³Water and settled sediment

From Table 2-1 of SRK's study. Rock fills most of each management pond's storage; water that could escape is a layer on top. SRK notes that the final mine plan lowered the West, East and control pond crests by two metres after modelling was done. Source: Dam Breach Assessment Report, SRK, Apr 2021, p. 15; Dam Breach Assessment Report, SRK, Apr 2021, p. 47.

Cross-section of the West Dam: an earth embankment with waste rock labelled PAG stored behind it up to near the crest, and a thin layer of water on top.

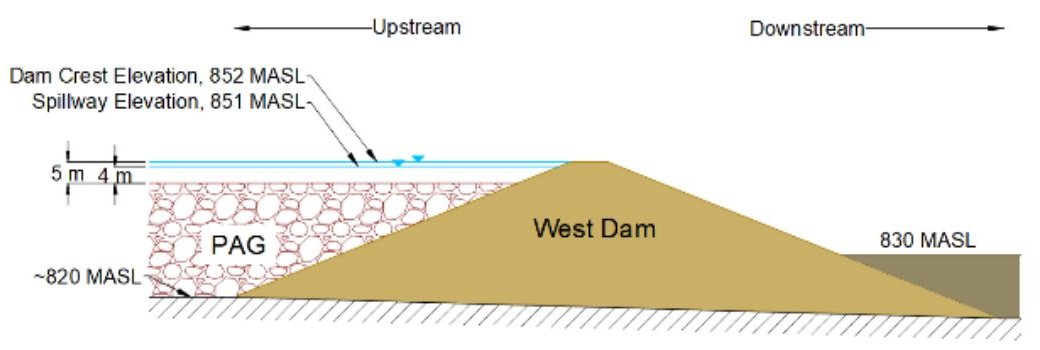

The West Dam in cross-section at the moment SRK treats as worst, from its Figure 3-1. PAG is acid-generating rock. A blue line marks water that would be released: four to five metres deep over rock.Open page 23 of this report.

Dams are to be built of waste rock and local soil: "well-graded sands, silts, and gravels near the surface, with larger quantities of fine sands at greater depths". Source: Dam Breach Assessment Report, SRK, Apr 2021, p. 15.

The ponds and dams year by year, from the engineering drawings →

Pond liners and seepage

The management ponds are designed to leak slowly. Each pond floor, and the inner face of each dam, carries a liner of local soil mixed with bentonite, a clay that swells when wet. The liner holds back enough water to keep the waste rock submerged, and lets a planned amount seep into the ground below. In answer to a public comment, Telkwa Coal put it this way: “Telkwa Coal has never stated that the ponds will not leak, in fact the opposite is true; they will leak at a controlled rate by the placement of engineered liner made of bentonite and soil.” Source: Public comments 1–559 with company responses, Nov 2022, comment 81-2.

Schematic cross-section of a management pond: water over saturated waste rock, a protective fabric and a thin soil-bentonite liner on native ground and up a dam's inner face, with seepage arrows passing down through that liner. dam crest buttress seepage to the creeks 1 2 3 4 5 6 7
Our schematic of a management pond, drawn from tables in SRK's reports. It is not to scale: liner and fabric are drawn several times thicker than built, so that they show. Numbers match this table.
#LayerThicknessPermeability, m/s
1Water coverat least 1 m, by design—
2Acid-generating waste rock, under watertens of metres1×10−5
3Heavy synthetic fabric that protects the linera few millimetresdoes not seal
4Soil-bentonite liner30 cm, laid in two layers1×10−10 or less, a target
5Natural ground: stiff clay, sand and gravel30 m or more under most of the ponds1.9–3.0×10−6
6Sedimentary bedrock of the Skeena Group—3.6×10−7
7Drain inside each dam, recommended by SRK—drains

Permeability is the speed at which water moves through a material when pushed by a slope of one metre per metre. Each step in the power of ten is a tenfold change: the liner is meant to be 20,000 to 30,000 times tighter than the ground beneath it. Sources: Liner Design and Construction Methodology, SRK, p. 4 (rows 4–6), p. 3 (row 1), p. 14 (ground), p. 16 (fabric); Management and Control Ponds Stability Assessment, SRK, Apr 2021, p. 30 (row 2), p. 11 (row 7).

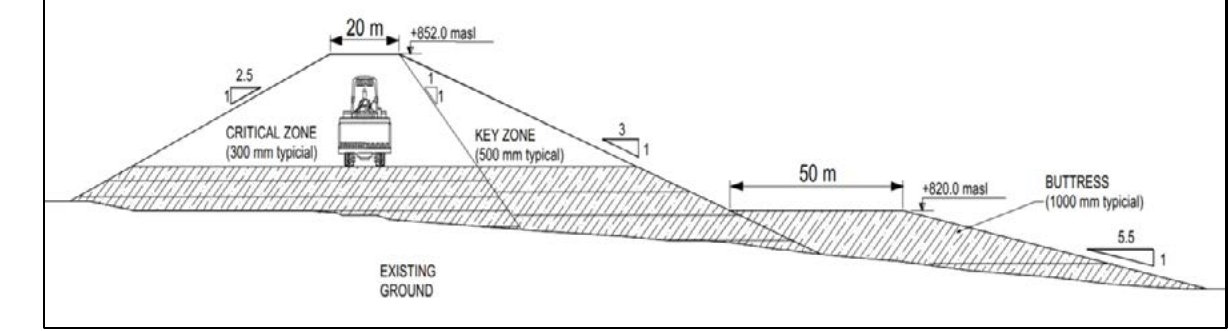

Engineering cross-section of the East Management Pond dam: a 20-metre-wide crest at 852 metres elevation, an inner slope of 2.5 to 1 on the pond side, an outer slope of 3 to 1, and a buttress with a 50-metre bench at 820 metres sloping away at 5.5 to 1, all built on existing ground.
The East pond's dam in cross-section, from Figure 7-1 of SRK's stability assessment. The pond is on the left. The parts of the dam marked “critical” and “key” are built in thin, well-compacted layers. This drawing is not to scale and does not show the liner. Open page 55 of this assessment.

Extent of lining

Construction and permeability target

Crews loosen the top 15 cm of natural soil, spread bentonite over it and mix it in. They lay a second 15 cm of soil, treat it the same way, and compact the 30 cm liner. A heavy synthetic fabric goes on top to keep waste rock from puncturing it. SRK compared the fabric with a one-metre cover of soil, and chose the fabric because it costs less and takes up no room in the pond. Source: Liner Design and Construction Methodology, SRK, pp. 15–16.

The liner's permeability of 1×10−10 m/s is a design target. No sample of the Tenas liner has yet been made or tested.

Seepage estimates

CaseSeepage, m³ a day
The most the ponds can lose in a dry decade and still keep 1 m of water over the rock, by SRK's water balance2,800
The same, in an average year4,260
No liner, SRK model, 20206,992
Chosen 30 cm liner, SRK model, 2020 (in brackets, if the ground is more permeable)1,736 (2,594)
Company's 2024 project case, end of mining: West 836, North 198, East 458, control pond 1401,632
Thicker liners studied in 2024, Option 1745
Thicker liners studied in 2024, Option 2531

Sources: Liner memo, p. 3, p. 9, p. 11; Water response, Part 1, p. 35.

At the 2024 figure, about 600,000 cubic metres a year would pass through the pond floors into the ground at the end of mining. That volume fills about 240 Olympic swimming pools. Earlier reports give 1,110 to 1,736 m³ a day, depending on the model.

Our rough check. At the target permeability, water creeps through the liner at about 3 mm a year when pushed only by a slope of one metre per metre. Under 30 m of water-filled rock, a 30 cm liner is pushed about a hundred times harder, so about 30 cm of water passes through each square metre each year. Over 1.9 million square metres of lined floor and dam face, that comes to about 1,700 m³ a day, close to SRK's 1,736. This check shows only that SRK's figure is the right size. The liner cuts seepage by about three-quarters, not by the 20,000-fold difference between liner and ground. We assess that without a liner, the limit is how fast groundwater can carry water away from the ponds, not how fast water can soak into the ground beneath them.

Seepage and creek water quality

Telkwa Mining's 2026 response names seepage as the cause of the predicted water-quality exceedances in two creeks: “the current proposed configuration active water treatment does not affect groundwater seepage which is the causes of elevated POCs in Four and Tenas Creeks.” POCs are parameters of concern, such as selenium, sulphate and nitrite. Source: Water response, Part 1, p. 45.

A tighter liner moves water rather than removing it. Less seeps down, so more pond water leaves over the North pond's spillway to Goathorn Creek. BC's environment ministry pointed out that the water on top of the North pond at times carries more selenium than the water held deeper in the rock, and asked for this trade-off to be modelled. Source: Water response, Part 1, p. 50.

Thicker liners studied in 2024

In 2024 SRK studied a 56 cm soil-bentonite liner under a 30 cm layer of compacted soil. One version added an asphalt-based membrane on the East pond. Either would cut seepage from the waste-rock ponds by half or more. Telkwa Mining's final plan does not adopt them. The thicker liner is held in reserve for the West pond, to be built if monitoring shows a need, and its design is left to the permitting stage. Lining the West pond's bedrock floor also stays open, if the other ponds turn out worse than predicted. Source: Water response, Part 1, pp. 34–35, p. 45.

Liner failure

Where our flood maps come from

Our map carries a set of dam breach flood overlays. They are figures from one document: Tenas Project Dam Breach Assessment Report, written by SRK Consulting for Telkwa Coal and dated April 2021. Telkwa Coal filed it with its 2022 Application as Appendix 1.0-AA, and again as Appendix 13.11-B. Forty-six of its map figures sit on our map, placed by matching each figure's aerial photograph to today's imagery.

Source: Dam Breach Assessment Report, SRK, Apr 2021, p. 3; Appendix 13.11-B, second copy of dam breach report, p. 1.

What SRK modelled

SRK chose two failures it judged to have worst consequences, and ran each in fair weather ("sunny day") and during an extreme flood ("rainy day"). Source: Dam Breach Assessment Report, SRK, Apr 2021, p. 13; Dam Breach Assessment Report, SRK, Apr 2021, p. 21.

FailureWeatherWater releasedReaches Telkwa inPeople, by SRK's estimate
West, North and control pond dams fail one after anotherFair6.5 million m³6 to 7 hoursAbout 120 affected
Flood8.3 million m³3 to 4 hoursAbout 150 moved to a higher hazard level
East Dam fails towards the mine buildingsFair6.3 million m³7 to 8 hoursUp to 200, among them up to 80 mine staff reached in under 1.5 hours
Flood7.4 million m³3 to 4 hours

Water released is the free water in Tables 3-1 and 3-2 of SRK's study; cascade totals are our sums over the three dams. Arrival times count from the start of each model run. Source: Dam Breach Assessment Report, SRK, Apr 2021, p. 25; Dam Breach Assessment Report, SRK, Apr 2021, p. 36; Dam Breach Assessment Report, SRK, Apr 2021, p. 38; Dam Breach Assessment Report, SRK, Apr 2021, p. 39; Dam Breach Assessment Report, SRK, Apr 2021, p. 44.

Two maps. Left: a band of flood hazard colours running from the mine site down the creeks and the Telkwa River to the village. Right: that band through the Village of Telkwa.

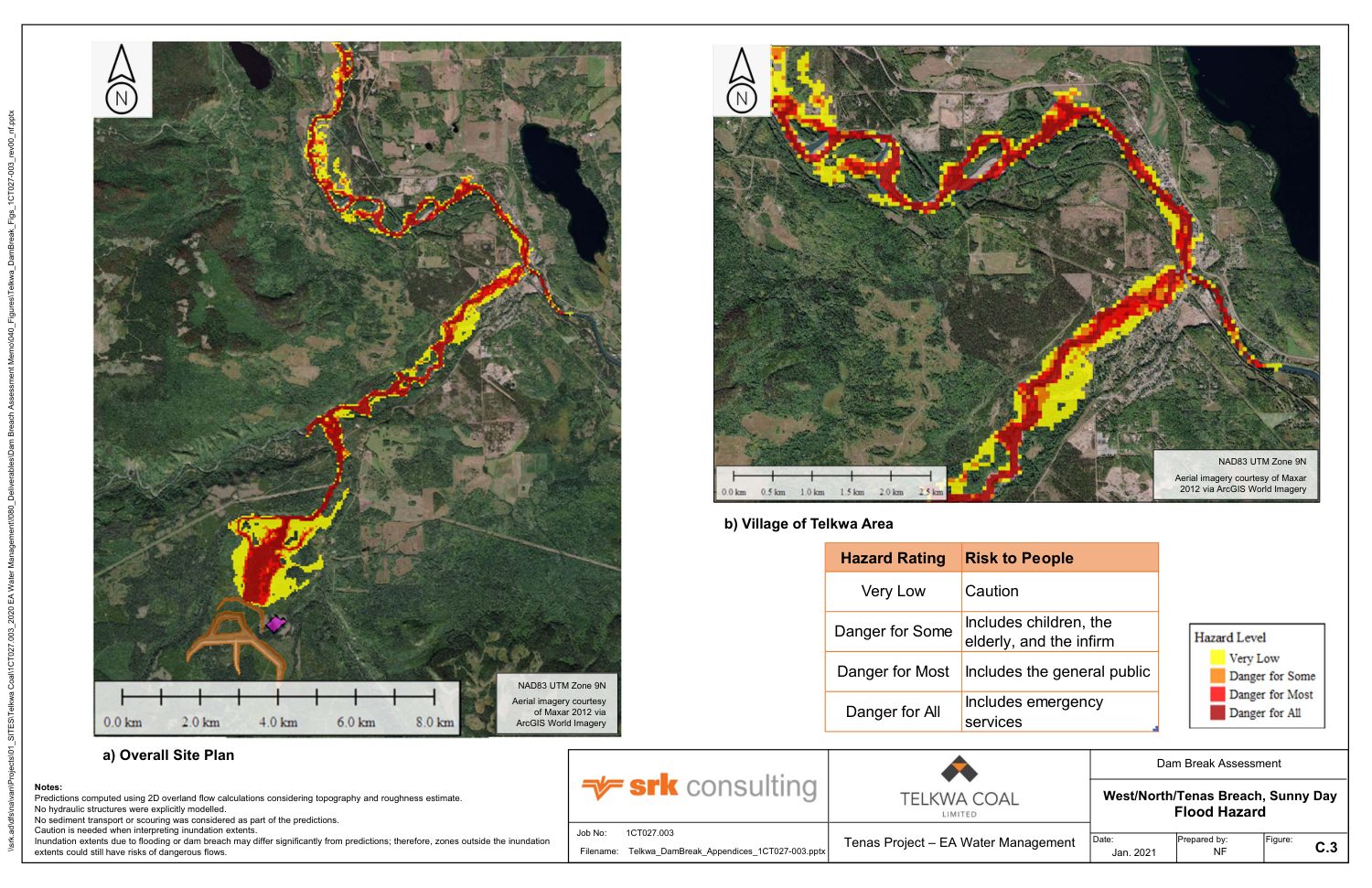

Fair-weather failure of the West, North and control pond dams: flood hazard (SRK's Figure C.3). Left, the whole path from the mine. Right, the Village of Telkwa. Yellow is the lowest hazard class and dark red the highest. Open page 66 of this report.On our map: whole path →On our map: Telkwa →
Both maps coloured by hours until water arrives: red near the mine, green at the village, purple downstream on the Bulkley River.

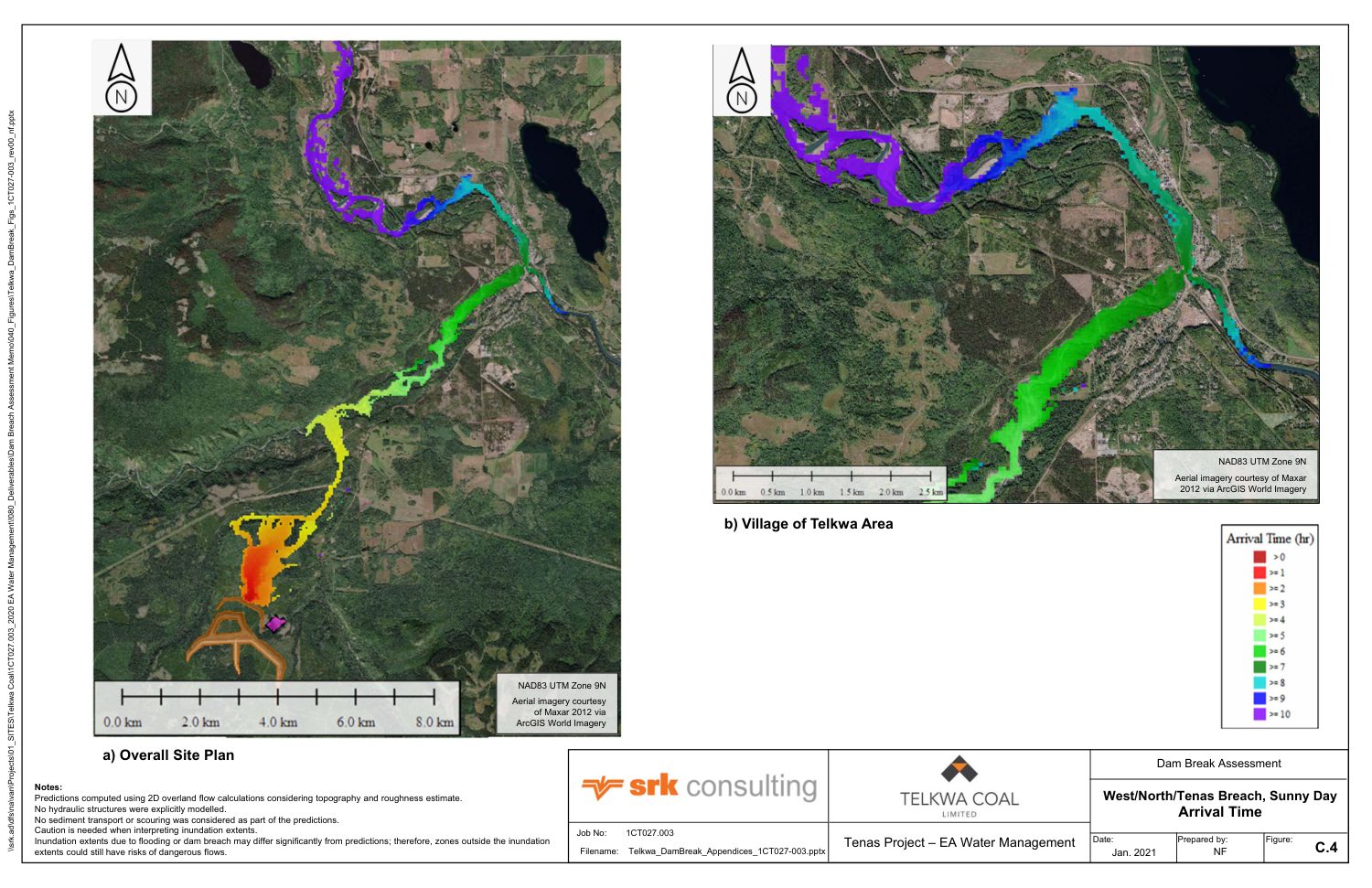

That failure, coloured by arrival time in hours (Figure C.4). Red marks the first hours, near the dams. Green, six to seven hours, marks where the Telkwa River meets the village. Open page 67 of this report.On our map: whole path →On our map: Telkwa →

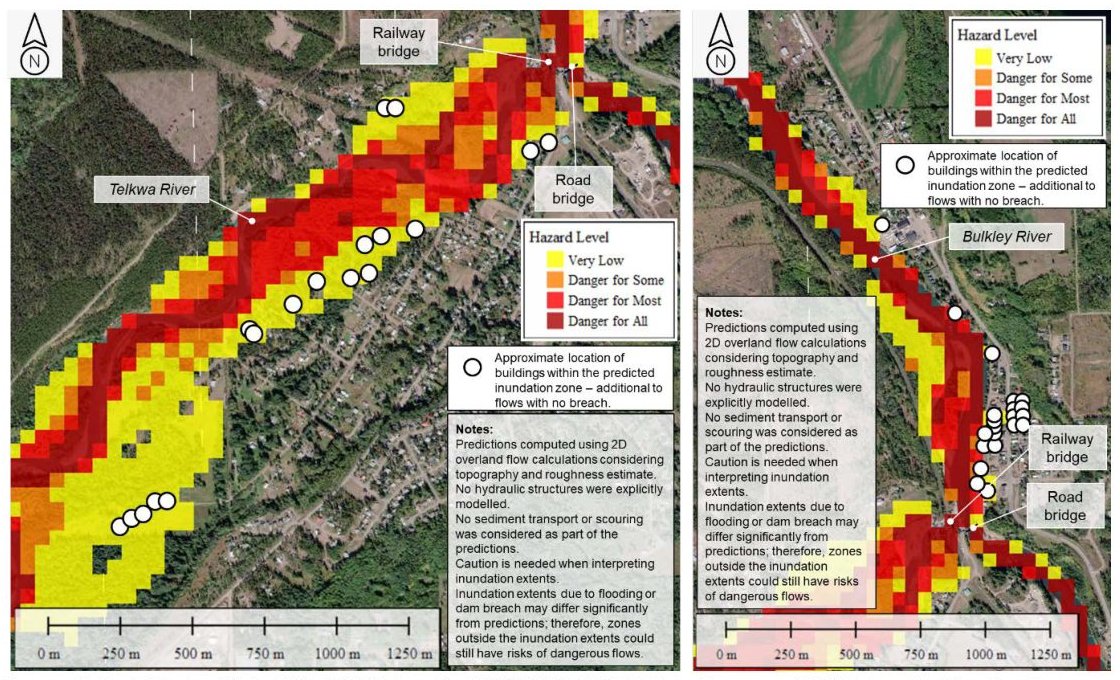

Close view of Telkwa in two panels, with hazard colours along both rivers and white circles marking buildings inside flooded ground.
Telkwa up close in that scenario (Figure 4-2). Each white circle marks a building SRK counts inside flooded ground. SRK assumed three people per building. Open page 34 of this report.On our map: south →On our map: north →
Two maps. Left: the flood path from the East Dam to the village. Right: the mine site, with a wide yellow area and dark red along Four Creek and Goathorn Creek.

Fair-weather failure of the East Dam: flood hazard (Figure E.3). Its right-hand panel is labelled "Village of Telkwa Area"; it shows the mine site. Open page 75 of this report.On our map: whole path →On our map: mine site →
Close view of the mine buildings pad just below the East Dam, inside flooded ground, with three buildings marked.

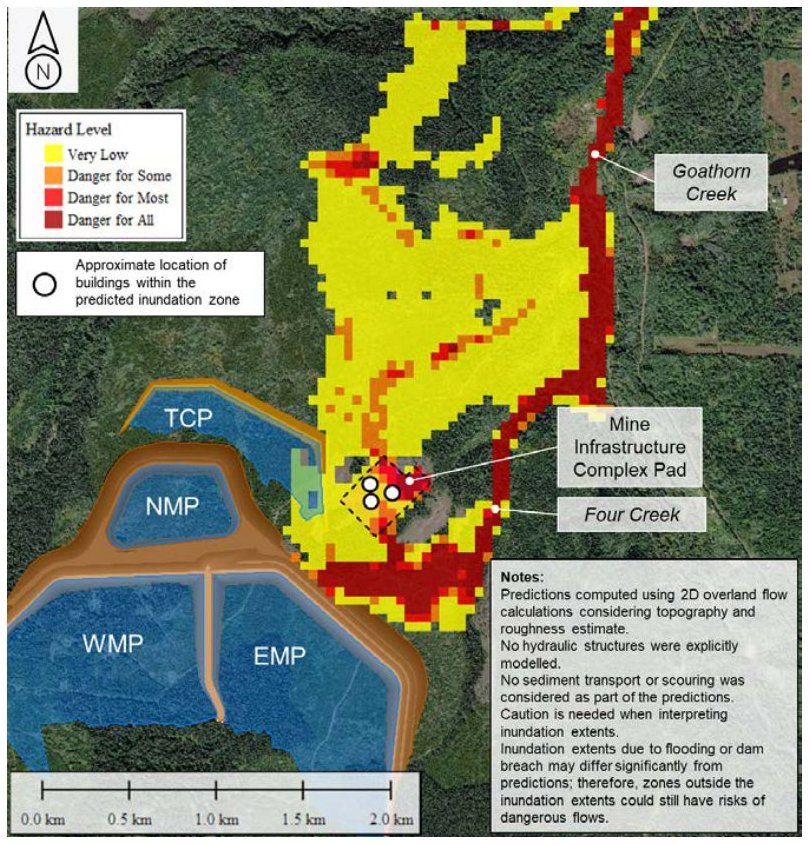

The mine's building complex in the East Dam scenario (Figure 4-4). Its pad floods to about 0.4 metres. About 28 staff work there at all hours and up to 80 at shift change. Open page 37 of this report.See it on our map →

"200 people" means people in a flood's path

SRK's number counts people inside the area a failure would flood, beyond those a natural flood would already reach. It counts people at risk. It is not a count of deaths. Source: Dam Breach Assessment Report, SRK, Apr 2021, p. 9; Dam Breach Assessment Report, SRK, Apr 2021, p. 41.

SRK sorts flooded ground into four hazard classes by water depth and speed:

Class on the mapsWho is in danger
Very Low"Caution"
Danger for Some"includes children, the elderly, and the infirm"
Danger for Most"includes the general public"
Danger for All"includes emergency services"
Source: Dam Breach Assessment Report, SRK, Apr 2021, p. 31; Dam Breach Assessment Report, SRK, Apr 2021, p. 32.

What SRK's study leaves out

SRK's report is plain about its limits.

What reviewers said, and what changed

BC's mines ministry reviewed these dams in 2022. Its comments became part of EAO's Water Information Request. Source: Water Information Request, Nov 23, 2022, p. 7; Water Information Request, Nov 23, 2022, p. 13; Water Information Request, Nov 23, 2022, p. 14.

Our reading of the 2026 water response →Review timeline →

What the Wet'suwet'en reviewers wrote

Two reports written for the Office of the Wet'suwet'en in 2022 treat a dam failure as this project's gravest risk.

SRK's study reaches the opposite view on environmental harm: that restoration is possible and the damage temporary.

What Indigenous nations filed →

What the record does not show

How we read it

We read the main body of SRK's dam breach report (pages 1 to 47) and the dam safety section of the 2024 answers in full, and looked at each figure shown here. For liners and seepage we read SRK's liner memo in full, its stability assessment's summary and liner-failure section, SkeenaWild's review at pages 8, 30 and 36, and Telkwa Mining's 2026 liner pages (Part 1, pages 33 to 35, 45 to 46 and 50). SRK's liner memo is dated April 19, 2020, yet uses pond geometry supplied on November 17, 2020 and cites an April 2021 report; we take its date to be a year early. We did not read the three attachments to the 2024 answers (the alternatives study, the earthquake study and the stability review).

Sources

  1. Dam Breach Assessment Report, SRK, Apr 2021
  2. Appendix 13.11-B, second copy of dam breach report
  3. Water response, Part 7 of 9, Jul 9, 2026
  4. Water Information Request, Nov 23, 2022
  5. Fish report for the Office of the Wet'suwet'en, May 2022
  6. Water report for the Office of the Wet'suwet'en, 2022
  7. Liner Design and Construction Methodology, SRK (Appendix 1.0-AC)
  8. Management and Control Ponds Stability Assessment, SRK, Apr 2021 (Appendix 1.0-L)
  9. Water response, Part 1 of 9, Jul 9, 2026
  10. SkeenaWild Conservation Trust, technical review, Jul 2022
  11. Company responses to groundwater public comments, SRK, Nov 2022
  12. Public comments 1–559 with company responses, Nov 2022
